A project will be undertaken in the wildlife park. This project involves the 13 activities shown in the table below. The duration, in hours, and predecessor(s) of each activity are also included in the table.

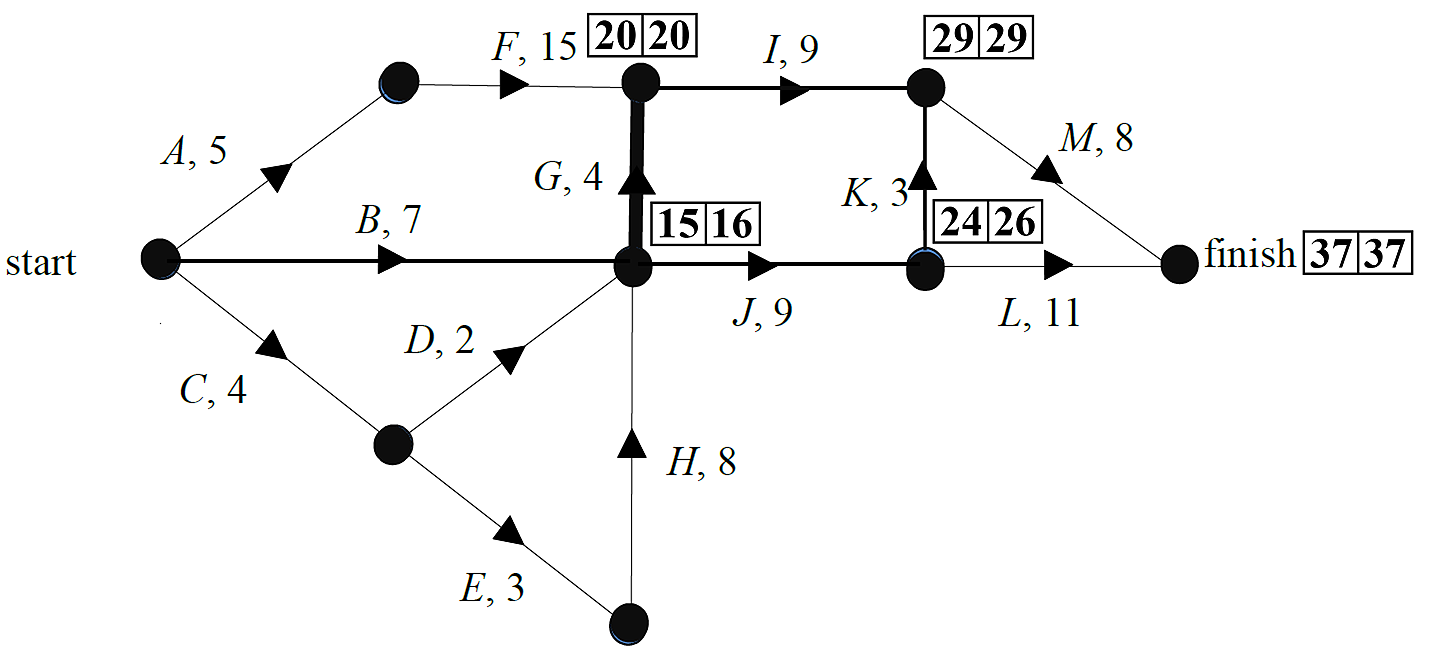

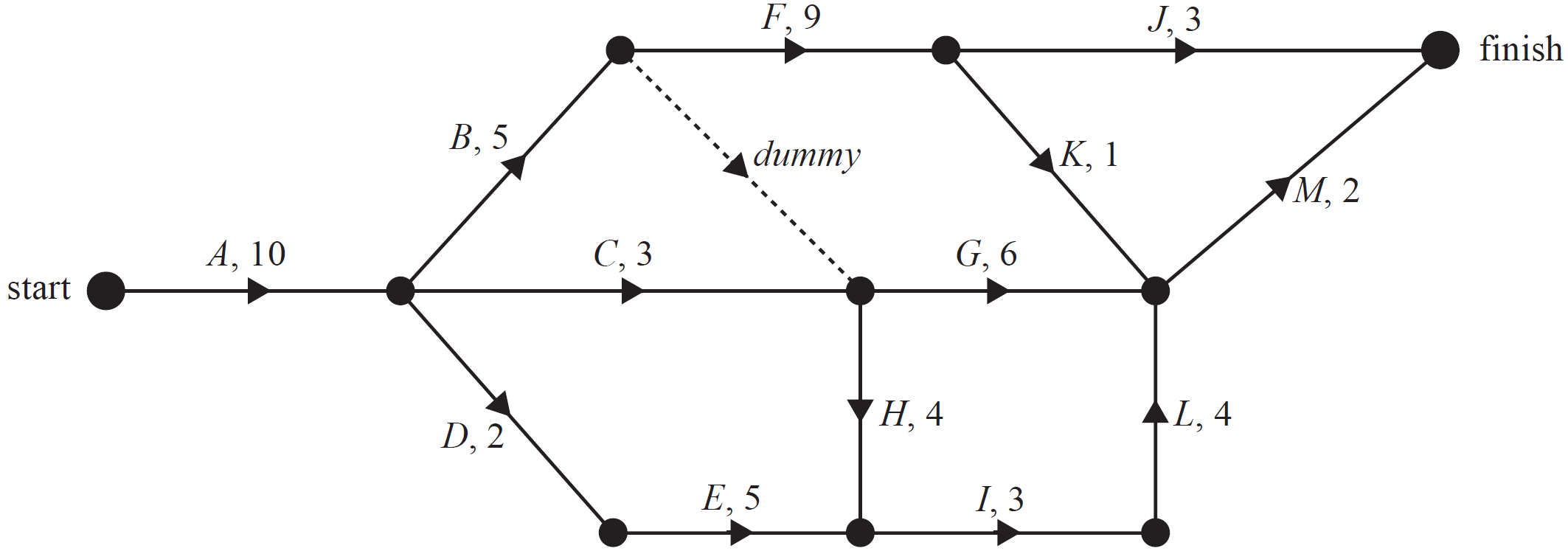

Activity `G` is missing from the network diagram for this project, which is shown below.

- Complete the network diagram above by inserting activity `G`. (1 mark)
--- 0 WORK AREA LINES (style=lined) ---
- Determine the earliest starting time of activity `H`. (1 mark)
--- 1 WORK AREA LINES (style=lined) ---
- Given that activity `G` is not on the critical path:
i. Write down the activities that are on the critical path in the order that they are completed. (1 mark)
--- 1 WORK AREA LINES (style=lined) ---
- ii. Find the latest starting time for activity `D`. (1 mark)
--- 5 WORK AREA LINES (style=lined) ---
- Consider the following statement.
‘If just one of the activities in this project is crashed by one hour, then the minimum time to complete the entire project will be reduced by one hour.’Explain the circumstances under which this statement will be true for this project. (1 mark)
--- 2 WORK AREA LINES (style=lined) ---
- Assume activity `F` is crashed by two hours.
What will be the minimum completion time for the project? (1 mark)
--- 3 WORK AREA LINES (style=lined) ---
